Rosland Park Pedestrian Bridge Replacement

Share Rosland Park Pedestrian Bridge Replacement on Facebook Share Rosland Park Pedestrian Bridge Replacement on Twitter Share Rosland Park Pedestrian Bridge Replacement on Linkedin Email Rosland Park Pedestrian Bridge Replacement link

The Rosland Park Pedestrian Bridge is a piece of critical transportation infrastructure that must be replaced. The bridge connects the north and south communities by providing a safe overpass bridge above Minnesota Highway 62. It is a critical connection for pedestrians from northern Edina to safely access Rosland Park and its amenities, including the Edina Aquatic Center.

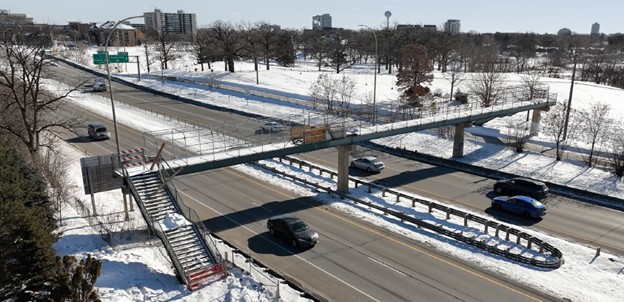

The current pedestrian bridge is owned and managed by the Minnesota Department of Transportation (MnDOT). It was built in the 1960s. The bridge does not meet Americans with Disabilities Act (ADA) standards and was substantially damaged when it was struck twice in 2022 by vehicles traveling on Minnesota Highway 62. The damage resulted in the closure of the bridge for most of 2022, until expensive temporary repairs were made in January 2023.

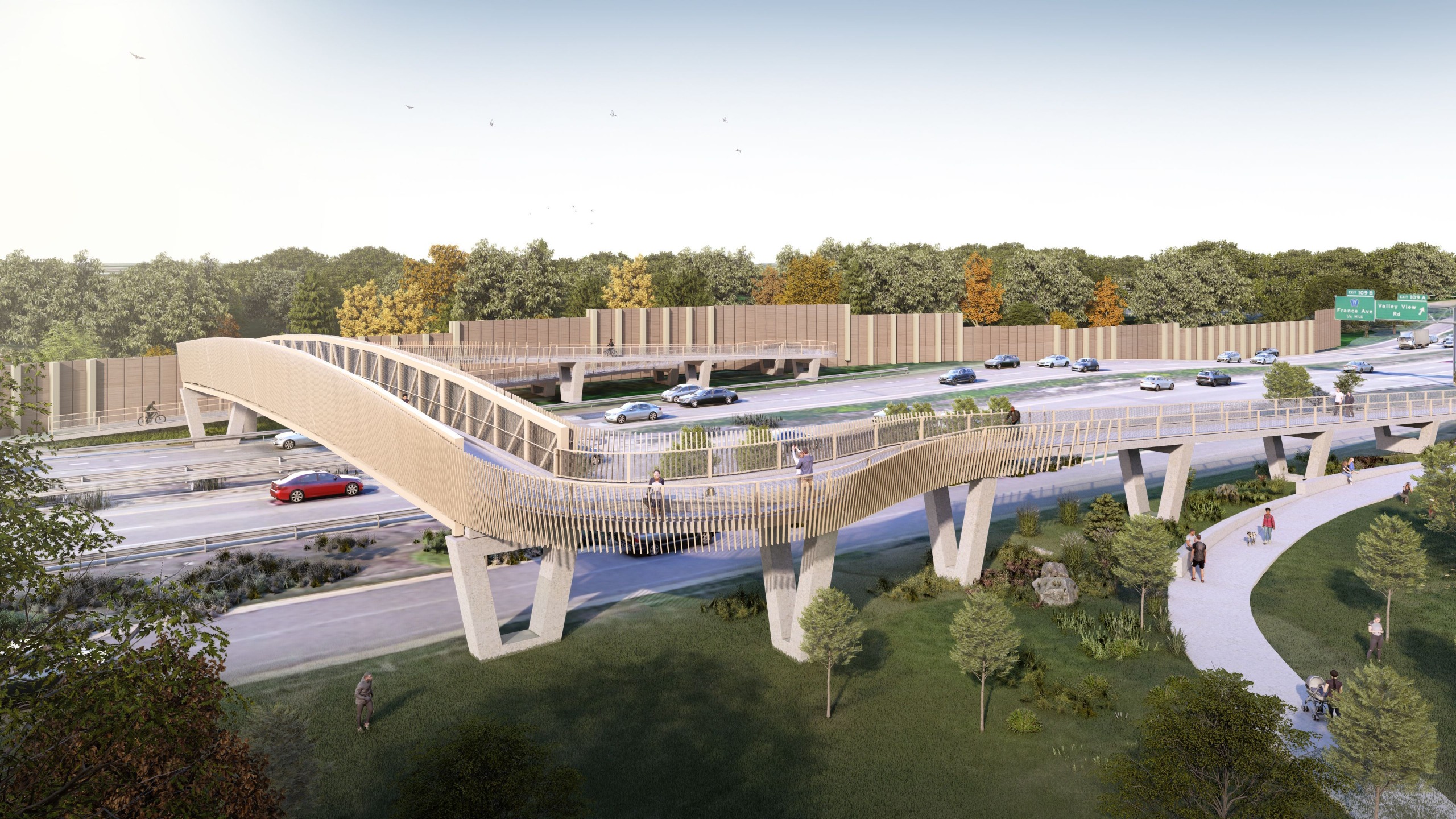

The City has started the preliminary design process for the new bridge. The approximately $6M project is fully funded with construction anticipated in 2025.


Project goals

  • Improve safety and mobility for all users
  • Create ADA compliant pedestrian and bike route
  • Improve connectivity between the residential neighborhoods and Rosland Park
  • Limit impacts on residential and park properties, trees, and road operations with an eye on long term operations and maintenance


The Rosland Park Pedestrian Bridge is a piece of critical transportation infrastructure that must be replaced. The bridge connects the north and south communities by providing a safe overpass bridge above Minnesota Highway 62. It is a critical connection for pedestrians from northern Edina to safely access Rosland Park and its amenities, including the Edina Aquatic Center.

The current pedestrian bridge is owned and managed by the Minnesota Department of Transportation (MnDOT). It was built in the 1960s. The bridge does not meet Americans with Disabilities Act (ADA) standards and was substantially damaged when it was struck twice in 2022 by vehicles traveling on Minnesota Highway 62. The damage resulted in the closure of the bridge for most of 2022, until expensive temporary repairs were made in January 2023.

The City has started the preliminary design process for the new bridge. The approximately $6M project is fully funded with construction anticipated in 2025.


Project goals

  • Improve safety and mobility for all users
  • Create ADA compliant pedestrian and bike route
  • Improve connectivity between the residential neighborhoods and Rosland Park
  • Limit impacts on residential and park properties, trees, and road operations with an eye on long term operations and maintenance


  • June 5, 2025 Update

    Share June 5, 2025 Update on Facebook Share June 5, 2025 Update on Twitter Share June 5, 2025 Update on Linkedin Email June 5, 2025 Update link

    Design of the Rosland Park Pedestrian Bridge continues. A great team of structural engineers, architects and a bridge fabricator are working on the project to ensure we are the most efficient with our time and better understand construction costs. The project is at a design milestone. It is approximately 30% designed. This means we can submit the 30% plans to MnDOT to start the discussion of requirements over Highway 62. This will be a unique discussion because of the decorative architecture panels. The estimated project cost was updated. Recall the project has a $6 million budget, all state funds. Construction costs and unknowns are increasing and affecting the budget. The project will mostly likely not be able to afford stairs features or be able to bury the overhead power lines. The cost estimate will be revisited after our discussions with MnDOT. Thanks, Chad Millner, City Engineer.

  • April 7, 2025 Project Update

    Share April 7, 2025 Project Update on Facebook Share April 7, 2025 Project Update on Twitter Share April 7, 2025 Project Update on Linkedin Email April 7, 2025 Project Update link

    A bridge fabricator has been hired and added to the team. Discussions continue on lots of details related to the steel truss bridge, landings, ramps, architectural panels, and user experience. The unique nature of the bridge requires us to figure out those details before engaging MnDOT on the bridge design. There are two major items affecting project budget – potential stairs and the camber of the steel truss bridge. Now that we have a bridge fabricator on the team, cost estimates will be more actual to determine what can be included in the project.

  • January 22, 2025 Project Update

    Share January 22, 2025 Project Update on Facebook Share January 22, 2025 Project Update on Twitter Share January 22, 2025 Project Update on Linkedin Email January 22, 2025 Project Update link
    supporting image

    The project team shared a project update with the City Council on January 21, 2025. The presentation slides can be found in the document area. The video of the discussion can be found here. https://edinamn.portal.civicclerk.com/ The team has been working on lots of details related to the steel truss bridge, landings, ramps, architectural panels, and user experience. The unique nature of the bridge requires us to hire a bridge fabricator to advance the 30% plans to bidding documents with less risk. There are two major items affecting project budget – potential stairs and the camber of the steel truss bridge. Once a bridge fabricator is added to the team, cost estimates will be more actual to determine what can be included in the project.

  • August 1, 2024 Project Update

    Share August 1, 2024 Project Update on Facebook Share August 1, 2024 Project Update on Twitter Share August 1, 2024 Project Update on Linkedin Email August 1, 2024 Project Update link

    Bolton Menk has finished the concept level work to study possible bridge concepts and determine what will fit best. They have also started working with the preferred architect, Snow Kreilich. Both firms need an opportunity to work on specific details related to the concept and structural engineering. They are looking at whether or not stairs could be added. They have also developed a project schedule. The new bridge will require an approval by the state bridge engineer and that takes time. Construction will most likely occurr in 2026. As updates occur, staff will be updating the BetterTogetherEdina website and City Council as appropriate.

  • Artist Rendering Update

    Share Artist Rendering Update on Facebook Share Artist Rendering Update on Twitter Share Artist Rendering Update on Linkedin Email Artist Rendering Update link
    supporting image

    At the June 18 City Council Meeting, the council discussed the artist rendering proposals. 3 of the members preferred the proposal submitted by Snow Kreilich. Staff has begun discussions with them and our structural engineer to start the design process. Thanks for all the feedback to date and we look forward to completing this very important project.

  • Artist Rendering Proposals

    Share Artist Rendering Proposals on Facebook Share Artist Rendering Proposals on Twitter Share Artist Rendering Proposals on Linkedin Email Artist Rendering Proposals link

    We received 3 responses to the Request for Proposals: Architectural Artistic Rendering for the Rosland Park Pedestrian Bridge. Each architect submitted a detailed pdf and 3 images. All the submittal materials can be found in the document section of this website. The City Council will be reviewing these at their June 18, 2024 City Council Meeting. Staff is looking for approval of a preferred concept. Thanks

  • Request for Artist Renderings

    Share Request for Artist Renderings on Facebook Share Request for Artist Renderings on Twitter Share Request for Artist Renderings on Linkedin Email Request for Artist Renderings link

    Staff has requested architectural artist renderings for the new Rosland Park Pedestrian Bridge. Four firms have been asked to respond to the request for proposals (RFP). The RFP is due on June 5, 2024. Staff will provide the RFP's to City Council on June 18 for further direction. Thanks

  • Council Direction from March 19, 2024 Meeting

    Share Council Direction from March 19, 2024 Meeting on Facebook Share Council Direction from March 19, 2024 Meeting on Twitter Share Council Direction from March 19, 2024 Meeting on Linkedin Email Council Direction from March 19, 2024 Meeting link

    Staff present a summary of the project to date and a recommendation to build switchbacks ramps with a steel truss bridge over Highway 62. Council officially removed elevators as an option but requested staff do more from an architectural perspective with the bridge and ADA switchback ramps. Staff will be researching higher quality architectural pedestrian bridges to better understand what may be possible and who could assist with this request. Thanks for your continued discussions on this project. Chad Millner

  • Staff Recommendation for March 19 Council Meeting

    Share Staff Recommendation for March 19 Council Meeting on Facebook Share Staff Recommendation for March 19 Council Meeting on Twitter Share Staff Recommendation for March 19 Council Meeting on Linkedin Email Staff Recommendation for March 19 Council Meeting link

    Staff will be seeking approval of Option #1A Switchback Ramps to the East for a new pedestrian bridge over Highway 62 at the March 19 City Council Meeting. There will not be an opportunity for public comment. The full report can be found in the documents area of this website. Staff is recommending this option for the following reasons.

    1. ADA accessible 100% of time.
    2. Typical highway crossing for pedestrians and cyclists commuting or recreation.
    3. Does not relocate the bridge and creating new sight line issues.
      1. Not located on the front side of houses or in front of bay windows.
    4. Switchbacks create slower speed for wheeled vehicles such as scooters, bicycles, etc.
    5. Best fits with available right-of-way.
    6. Fits with future noise wall and allows some adjustment if necessary.
    7. Minimal maintenance required compared to elevators.
    8. Snow removal completed by city staff with existing equipment.
    9. Less tree removals than all options except elevators.
    10. Within available budget.

    Following approval of a design option, staff would create a community engagement plan to develop the aesthetic features of the bridge such as railings, the finish on the ADA ramps, and lights that meet MnDOT requirements.

  • Two More Renderings

    Share Two More Renderings on Facebook Share Two More Renderings on Twitter Share Two More Renderings on Linkedin Email Two More Renderings link
    supporting image

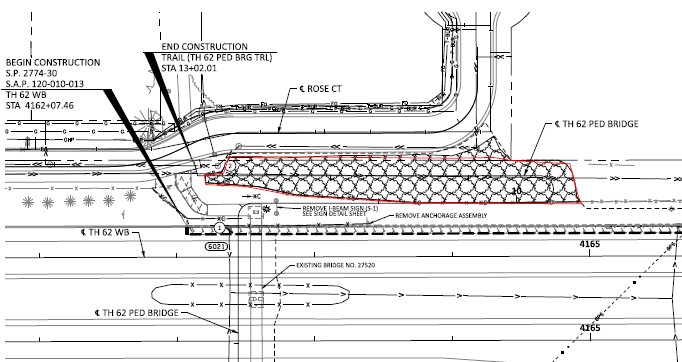

    Two more renderings have been created and attached in the document area. They are views north of 64th Street without the noise wall. Thanks
