York Avenue Trunk Sanitary
The project includes design and construction of a new trunk sanitary sewer pipe and manholes in the southbound lanes of York Avenue (CSAH 31) between the Promenade and 69th Street West intersection. The improvements are listed in the 2023-2028 Capital Improvement Plan (CIP) under CIP #19-335 and are funded by the sanitary sewer utility.
Planned construction is for Summer/Fall 2025
The scope of construction includes;

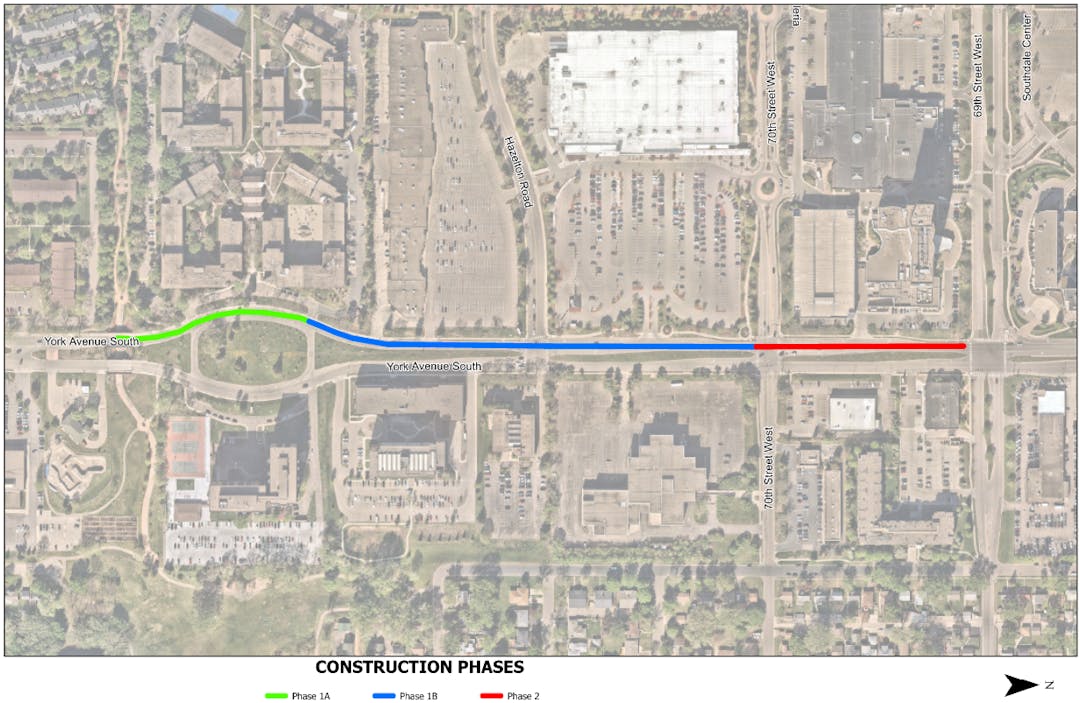

- 2 phases of construction over 4 months to construct new and upgraded Sanitary sewer pipe
 - Phased closures of southbound York between the Promenade and 69th Street West
 - New sections of road, curb, crosswalks and catch basins

The project includes design and construction of a new trunk sanitary sewer pipe and manholes in the southbound lanes of York Avenue (CSAH 31) between the Promenade and 69th Street West intersection. The improvements are listed in the 2023-2028 Capital Improvement Plan (CIP) under CIP #19-335 and are funded by the sanitary sewer utility.
Planned construction is for Summer/Fall 2025
The scope of construction includes;
- 2 phases of construction over 4 months to construct new and upgraded Sanitary sewer pipe
 - Phased closures of southbound York between the Promenade and 69th Street West
 - New sections of road, curb, crosswalks and catch basins

-
Project Wrap Up & Thank You
Share Project Wrap Up & Thank You on Facebook Share Project Wrap Up & Thank You on Twitter Share Project Wrap Up & Thank You on Linkedin Email Project Wrap Up & Thank You linkThank you for your patience, curiosity, questions and support as we completed this 3rd phase of the York Avenue Trunk Sanitary.
We'll be back for segment 4, 69th to 66th section in 2027 or 2028. Follow these and other construction projects as we engaged neighbors and community members and reinvest in, and renew our aging infrastructure;
Street Reconstruction Map: https://www.bettertogetheredina.org/streetprojects
Development tracker: https://experience.arcgis.com/experience/16c287e067034e5ea4410d7dec20a538/
 -
Construction Update 10/28
Share Construction Update 10/28 on Facebook Share Construction Update 10/28 on Twitter Share Construction Update 10/28 on Linkedin Email Construction Update 10/28 linkThis week
- Installation of traffic signs and pavement markings
 - Repair and programming of traffic signals
 - Final testing of sewer line, installation of internal drop structures
 - Final clean-up
 - The probable reopening of the southbound lane late Thursday or Early Friday

Please note any items of coordination and direct any questions to William Bauer, SEH, and Ross Bintner, City of Edina
 -
Detour safety
Share Detour safety on Facebook Share Detour safety on Twitter Share Detour safety on Linkedin Email Detour safety linkEastbound 69th and Hazelton remain closed - Follow the France Avenue detours – avoid dangerous and illegal cut though maneuvers.
Law enforcement will continue enforcing the wrong way and illegal traffic movements in the area. Avoid an expensive ticket and stay safe!
 -
Construction Update 10/21 (Current Week & 10/27)
Share Construction Update 10/21 (Current Week & 10/27) on Facebook Share Construction Update 10/21 (Current Week & 10/27) on Twitter Share Construction Update 10/21 (Current Week & 10/27) on Linkedin Email Construction Update 10/21 (Current Week & 10/27) linkKey Update
- Next Week: We project the probable reopening of southbound York Avenue on Thursday 10/30, or Friday 10/31.

This week
- Seeding and placement of new sod
 - Preparation for and paving of final layer of new roadway
 - Signal and push button reestablishment

Week of 10/27
- Installation of traffic signs and pavement markings
 - Final clean-up
 - The probable reopening of the southbound lane Thursday or Friday
- As always - weather dependent!


Please note any items of coordination and direct any questions to William Bauer, SEH, and Ross Bintner, City of Edina
 -
Construction Update 10/14 (current week, 10/20, 10/27)
Share Construction Update 10/14 (current week, 10/20, 10/27) on Facebook Share Construction Update 10/14 (current week, 10/20, 10/27) on Twitter Share Construction Update 10/14 (current week, 10/20, 10/27) on Linkedin Email Construction Update 10/14 (current week, 10/20, 10/27) linkThanks for keeping up to speed with us as the project develops. Keep in mind this information will change as the course of construction and weather affect our work.
Key Update
- SEPARATE PROJECT IS CLOSING NORTHBOUND YORK FOR UP TO 2 WEEKS - October 15 - 31
- Northbound York Avenue (County Road 31) is closed between Hazelton Road and 70th Street. Crews will connect sanitary sewer and water lines for the future Southdale Library. Follow the posted detour. For more information, visit the Southdale Library construction page(External link). https://beheardhennepin.org/southdale-library(External link)

 - Southbound York Avenue is on schedule to re-open to traffic around the end of October.

This week
- Paving of asphalt driveways and the first two layers of the new roadway.
 - Placement of topsoil and preparation for seed/sod

Week of 10/20
- Seeding and placement of new sod
 - Preparation for and paving of final layer of new roadway
 - Signal and push button reestablishment

Week of 10/27
- Installation of traffic signs and pavement markings
 - Final clean-up

Please note any items of coordination and direct any questions to William Bauer, SEH, and Ross Bintner, City of Edina
 - SEPARATE PROJECT IS CLOSING NORTHBOUND YORK FOR UP TO 2 WEEKS - October 15 - 31
 -
Construction Update 10/8 (current week, 10/13, 10/20)
Share Construction Update 10/8 (current week, 10/13, 10/20) on Facebook Share Construction Update 10/8 (current week, 10/13, 10/20) on Twitter Share Construction Update 10/8 (current week, 10/13, 10/20) on Linkedin Email Construction Update 10/8 (current week, 10/13, 10/20) linkThanks for keeping up to speed with us as the project develops. Keep in mind this information will change as the course of construction and weather affect our work.
Key Update
- SEPERATE PROJECT IS CLOSING NORTHBOUND YORK FOR 2 WEEKS - October 15 - 31
- Northbound York Avenue (County Road 31) is closed between Hazelton Road and 70th Street. Crews will connect sanitary sewer and water lines for the future Southdale Library. Follow the posted detour. For more information, visit the Southdale Library construction page. https://beheardhennepin.org/southdale-library


This week
- Placement of new concrete curb and gutter.
 - Preparation and pouring of new sidewalk and driveways.

Week of 10/13
- Paving of asphalt driveways and the first layer of the new roadway.
 - Placement of topsoil and preparation for seed
 - Seeding late week or early the following

Week of 10/20
- Paving of second layer of new roadway
 - Preparation for pavement marking
 - Signal and push button reestablishment
 - Prepare new signs, install the following week

Please note any items of coordination and direct any questions to William Bauer, SEH, and Ross Bintner, City of Edina
 - SEPERATE PROJECT IS CLOSING NORTHBOUND YORK FOR 2 WEEKS - October 15 - 31
 -
Construction Update 10/1 (current week, 10/6, 10/13)
Share Construction Update 10/1 (current week, 10/6, 10/13) on Facebook Share Construction Update 10/1 (current week, 10/6, 10/13) on Twitter Share Construction Update 10/1 (current week, 10/6, 10/13) on Linkedin Email Construction Update 10/1 (current week, 10/6, 10/13) linkThanks for keeping up to speed with us as the project develops. Keep in mind this information will change as the course of construction and weather affect our work.
This week
- Grading for the new roadway is underway
 - Placement of gravel for the new roadway base will also begin this week

Week of 10/6
- Placement of gravel for the new roadway base.
 - Placement of new concrete curb and gutter.
 - Preparation and pouring of new sidewalk and driveways.

Week of 10/13
- Paving of asphalt driveways and the first layer of the new roadway.

Please note any items of coordination and direct any questions to William Bauer, SEH, and Ross Bintner, City of Edina
 -
Construction Update 9/24 (current week, 9/29, 10/6)
Share Construction Update 9/24 (current week, 9/29, 10/6) on Facebook Share Construction Update 9/24 (current week, 9/29, 10/6) on Twitter Share Construction Update 9/24 (current week, 9/29, 10/6) on Linkedin Email Construction Update 9/24 (current week, 9/29, 10/6) linkThanks for keeping up to speed with us as the project develops. Keep in mind this information will change as the course of construction and weather affect our work.
This week
- Completion of new sanitary sewer pipe is expected by the end of the week.
 - Private utility companies will be on site to prepare their facilities for backfill.

Week of 9/28
- CenterPoint Energy crews will be working in the area to install a new gas main on 69th Street from York Ave to approximately 400' east.
 - Grading for new roadway and placement of gravel for the new roadway base.

Week of 10/6
- Placement of gravel for the new roadway base.
 - Placement of new concrete curb and gutter.
 - Preparation to pour new sidewalk.

Please note any items of coordination and direct any questions to William Bauer, SEH, and Ross Bintner, City of Edina
 -
Water Restored - 9/19/2025
Share Water Restored - 9/19/2025 on Facebook Share Water Restored - 9/19/2025 on Twitter Share Water Restored - 9/19/2025 on Linkedin Email Water Restored - 9/19/2025 link
The crews completed the water valve repair at approximately 7:30 PM. You may resume using your water! We're sorry for the inconvenience.
 -
Water Shutoff Update - 9/19/2025
Share Water Shutoff Update - 9/19/2025 on Facebook Share Water Shutoff Update - 9/19/2025 on Twitter Share Water Shutoff Update - 9/19/2025 on Linkedin Email Water Shutoff Update - 9/19/2025 link
A water valve tied to the sanitary sewer project failed today, 9/19, and water is currently shut off to multiple apartments and properties. Crews are on it, but we don’t yet know exactly how long it will take — we’re hoping to have water service back by 6 PM. Sorry for the inconvenience and thanks for hanging in there with us!

Who's Listening
-
Phone 952-903-5713 Email RBintner@EdinaMN.gov  -
Phone 952-912-2629 Email wbauer@sehinc.com  -
Phone 612-251-6956 Email jharrington@sehinc.com
Documents
FAQs
- What is the purpose of the York Avenue Trunk Sanitary Sewer Project?
 - What work is included in the project, and will the area look any different when it’s finished?
 - When is construction happening?
 - How will traffic be affected during the project?
 - Are there any anticipated service disruptions during construction?
 - How much does the project cost and how is it funded?
 - How can I stay informed about the project?
 - Who can I contact with questions?
