Presidents A & B Neighborhood Roadway Reconstruction

Share Presidents A & B Neighborhood Roadway Reconstruction on Facebook Share Presidents A & B Neighborhood Roadway Reconstruction on X (formerly Twitter) Share Presidents A & B Neighborhood Roadway Reconstruction on Linkedin Email Presidents A & B Neighborhood Roadway Reconstruction link

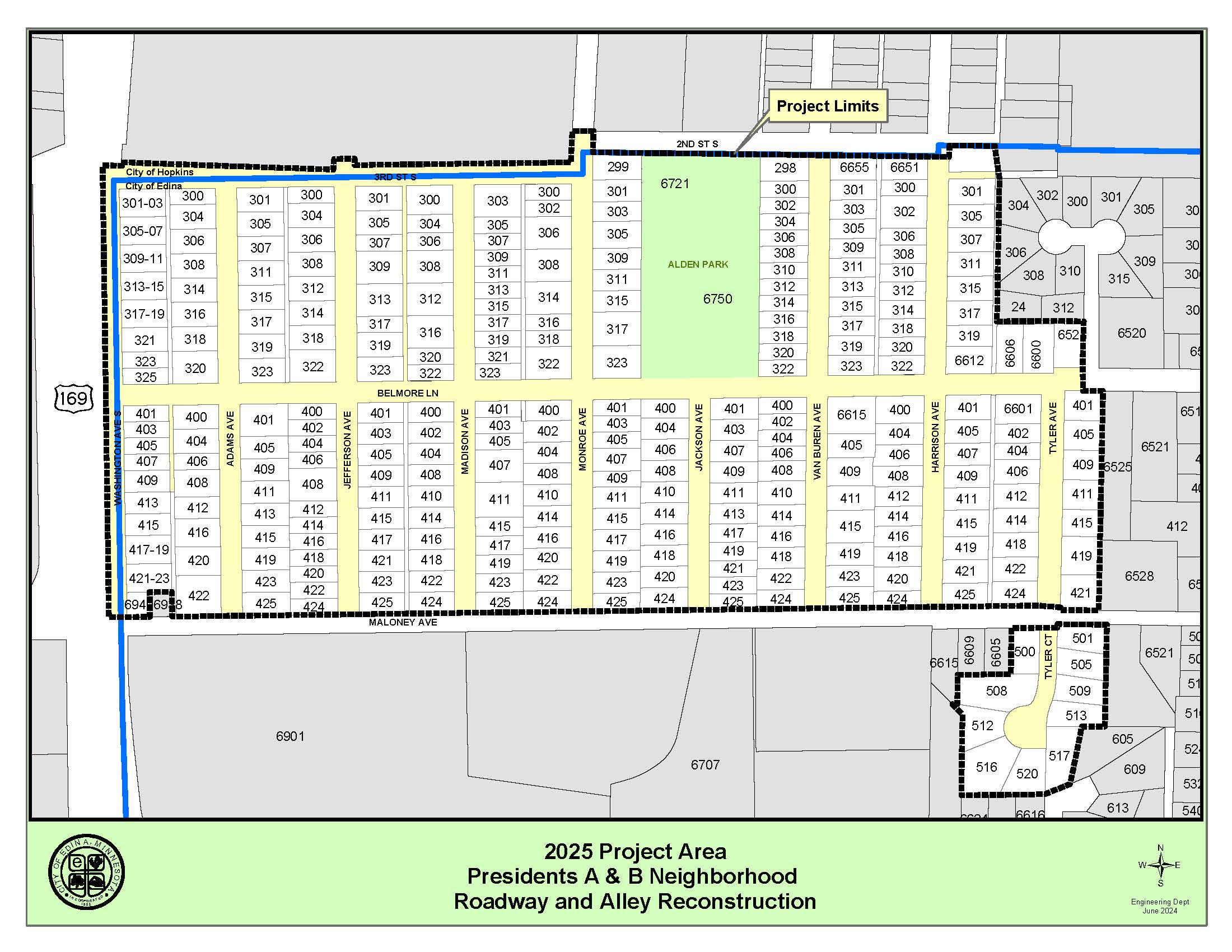

Map showing the Presidents neighborhood and the project limit boundaries.

Presidents A & B Neighborhood Roadway Reconstruction updates will be hosted on this project page. Sign up for email updates!

This 2025 construction project includes:

  • Complete reconstruction of the roadway asphalt pavement,
  • Full installation or replacement of concrete curb and gutter,
  • Complete reconstruction of two alleys west of Madison Avenue,

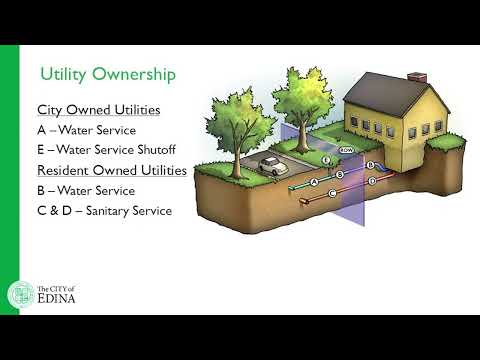

  • Complete replacement of the watermain and water services,
  • Improvements to the sanitary sewer and storm sewer systems, and
  • Proposed construction of multi-modal facilities along:

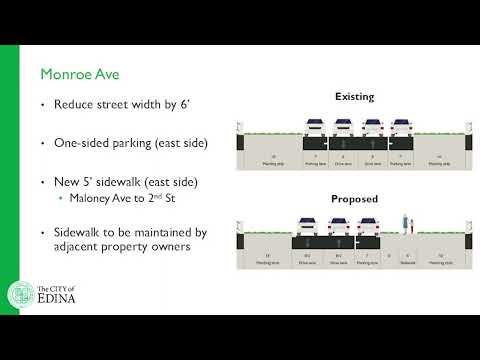

    • Monroe Avenue (5' sidewalk)
    • Belmore Lane (8' shared use path)
    • Washington Avenue (8' shared use path)

  • The project is funded by a combination of special assessments, property taxes, respective utility funds and the Pedestrian and Cyclist Safety (PACS) fund
  • A preliminary assessment of $8,600 per Residential Equivalent Unit is proposed for the roadway improvements.
  • An additional preliminary assessment amount of $1,300 per Residential Equivalent Unit is proposed for the gravel alley improvements for the properties bordering the alley between Washington and Adams Avenues.
  • If unforeseen changes do not occur during construction, an assessment cost savings of up to 20% could occur.

Presidents A & B Neighborhood Roadway Reconstruction updates will be hosted on this project page. Sign up for email updates!

This 2025 construction project includes:

  • Complete reconstruction of the roadway asphalt pavement,
  • Full installation or replacement of concrete curb and gutter,
  • Complete reconstruction of two alleys west of Madison Avenue,
  • Complete replacement of the watermain and water services,
  • Improvements to the sanitary sewer and storm sewer systems, and
  • Proposed construction of multi-modal facilities along:
    • Monroe Avenue (5' sidewalk)
    • Belmore Lane (8' shared use path)
    • Washington Avenue (8' shared use path)
  • The project is funded by a combination of special assessments, property taxes, respective utility funds and the Pedestrian and Cyclist Safety (PACS) fund
  • A preliminary assessment of $8,600 per Residential Equivalent Unit is proposed for the roadway improvements.
  • An additional preliminary assessment amount of $1,300 per Residential Equivalent Unit is proposed for the gravel alley improvements for the properties bordering the alley between Washington and Adams Avenues.
  • If unforeseen changes do not occur during construction, an assessment cost savings of up to 20% could occur.
  • Substantial Completion

    Share Substantial Completion on Facebook Share Substantial Completion on X (formerly Twitter) Share Substantial Completion on Linkedin Email Substantial Completion link

    The Presidents A & B Street Reconstruction project is substantially complete. The contractor will address the following remaining items in the summer of 2026 as part of final completion.

    • Roadway striping on Washington Avenue.
    • Watering of sod will continue for temporarily. Following acceptance of the sod in fall 2026, property owners will be responsible for the new sod.
    • Sanitary sewer lining on Tyler Ave and Tyler Ct.
    • Remaining landscaping replacement as needed.
    • Warranty repairs (2026/2027)

    The City of Edina and Valley Paving thank you for your patience and cooperation throughout the 2025 and 2026 construction seasons.

    The Presidents A & B Street Reconstruction project is substantially complete. The contractor will address the following remaining items in the summer of 2026 as part of final completion.

    • Roadway striping on Washington Avenue.
    • Watering of sod will continue for temporarily. Following acceptance of the sod in fall 2026, property owners will be responsible for the new sod.
    • Sanitary sewer lining on Tyler Ave and Tyler Ct.
    • Remaining landscaping replacement as needed.
    • Warranty repairs (2026/2027)

    The City of Edina and Valley Paving thank you for your patience and cooperation throughout the 2025 and 2026 construction seasons.

  • Construction Update - 7/17/2026

    Share Construction Update - 7/17/2026 on Facebook Share Construction Update - 7/17/2026 on X (formerly Twitter) Share Construction Update - 7/17/2026 on Linkedin Email Construction Update - 7/17/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until 7/24. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Paving the final layer of asphalt is tentatively scheduled for Tuesday, July 21 (weather permitting).
      • See more information about paving here, particularly regarding avoiding the sticky asphalt surface application, parking restrictions, etc.
    • Remaining landscaping replacement and tree installation is ongoing for the next several weeks.
    • Sanitary sewer structural lining is scheduled for early August.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until 7/24. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Paving the final layer of asphalt is tentatively scheduled for Tuesday, July 21 (weather permitting).
      • See more information about paving here, particularly regarding avoiding the sticky asphalt surface application, parking restrictions, etc.
    • Remaining landscaping replacement and tree installation is ongoing for the next several weeks.
    • Sanitary sewer structural lining is scheduled for early August.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Asphalt Paving Phase 4

    Share Asphalt Paving Phase 4 on Facebook Share Asphalt Paving Phase 4 on X (formerly Twitter) Share Asphalt Paving Phase 4 on Linkedin Email Asphalt Paving Phase 4 link

    The final layer of asphalt is scheduled to be paved on Tuesday, July 21 starting at 7 AM, weather permitting. You will get a door hanger the day before paving.

    Parking Restrictions:

    • No parking on the street: Please do not park any vehicles on the street until the roadway has been completely paved. You risk your vehicle being towed.
    • Parking alternative: Parking in your garage or driveway is acceptable. Otherwise, park any vehicles you will need on July 14 on
      • Maloney Ave
      • Van Buren Ave
      • 2nd St
      • Dearborn Ct
    • The entire roadway must remain clear for crews to sweep, prepare, and pave the surface.

    Important Notes:

    1. Asphalt Bonding Application:
      Before paving, crews will apply a sticky liquid on top of the existing pavement before laying down the final asphalt layer. It’s a thin, black coating that acts like glue, helping the new asphalt stick better to the old surface.
      • Sticky surface: Because it's sticky, if you drive through it before the new asphalt is laid, it can get on your car tires and leave permanent marks on your vehicle and driveway. If you need to get out of your driveway before the asphalt is paved, you may do so, but please go slow so it will not track onto your vehicle. The City will not be responsible for removing this.
      • Prevent driveway access: If you wish to deter others from using your driveway as a turnaround, place your garbage cans at the bottom of your driveway for the day.
    2. Contractors/Personal Services:
      Please inform any contractors or personal services (e.g., cleaners, landscapers) about this schedule so they can plan accordingly.

    After Paving:

    • Rolling and Compaction: Once the new asphalt is placed, large rollers will compact the surface. If you must drive on the freshly paved street, please do so slowly and avoid sharp turns to prevent damage to the new pavement.
    • Vehicle Return: Once the paving and rolling are complete, you may return your vehicles to your driveway.

    The final layer of asphalt is scheduled to be paved on Tuesday, July 21 starting at 7 AM, weather permitting. You will get a door hanger the day before paving.

    Parking Restrictions:

    • No parking on the street: Please do not park any vehicles on the street until the roadway has been completely paved. You risk your vehicle being towed.
    • Parking alternative: Parking in your garage or driveway is acceptable. Otherwise, park any vehicles you will need on July 14 on
      • Maloney Ave
      • Van Buren Ave
      • 2nd St
      • Dearborn Ct
    • The entire roadway must remain clear for crews to sweep, prepare, and pave the surface.

    Important Notes:

    1. Asphalt Bonding Application:
      Before paving, crews will apply a sticky liquid on top of the existing pavement before laying down the final asphalt layer. It’s a thin, black coating that acts like glue, helping the new asphalt stick better to the old surface.
      • Sticky surface: Because it's sticky, if you drive through it before the new asphalt is laid, it can get on your car tires and leave permanent marks on your vehicle and driveway. If you need to get out of your driveway before the asphalt is paved, you may do so, but please go slow so it will not track onto your vehicle. The City will not be responsible for removing this.
      • Prevent driveway access: If you wish to deter others from using your driveway as a turnaround, place your garbage cans at the bottom of your driveway for the day.
    2. Contractors/Personal Services:
      Please inform any contractors or personal services (e.g., cleaners, landscapers) about this schedule so they can plan accordingly.

    After Paving:

    • Rolling and Compaction: Once the new asphalt is placed, large rollers will compact the surface. If you must drive on the freshly paved street, please do so slowly and avoid sharp turns to prevent damage to the new pavement.
    • Vehicle Return: Once the paving and rolling are complete, you may return your vehicles to your driveway.
  • Construction Update - 7/10/2026

    Share Construction Update - 7/10/2026 on Facebook Share Construction Update - 7/10/2026 on X (formerly Twitter) Share Construction Update - 7/10/2026 on Linkedin Email Construction Update - 7/10/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until 7/17. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Paving the final layer of asphalt is tentatively scheduled for Tuesday, July 14th (weather permitting).
      • See more information about paving here.
    • Sod installation is nearly complete.
      • See written and video sod care tips here and here.
      • To prevent sod damage, please avoid walking on or mowing it initially.
      • The contractor will be watering for the first 60 days.
      • If there is little rainfall and hot temperatures, supplemental daily watering from property owners is appreciated.
    • Sanitary sewer structural lining is scheduled for late July.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until 7/17. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Paving the final layer of asphalt is tentatively scheduled for Tuesday, July 14th (weather permitting).
      • See more information about paving here.
    • Sod installation is nearly complete.
      • See written and video sod care tips here and here.
      • To prevent sod damage, please avoid walking on or mowing it initially.
      • The contractor will be watering for the first 60 days.
      • If there is little rainfall and hot temperatures, supplemental daily watering from property owners is appreciated.
    • Sanitary sewer structural lining is scheduled for late July.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Construction Update - 7/2/2026

    Share Construction Update - 7/2/2026 on Facebook Share Construction Update - 7/2/2026 on X (formerly Twitter) Share Construction Update - 7/2/2026 on Linkedin Email Construction Update - 7/2/2026 link

    Project Area

    • No work will occur on Friday, July 3rd in observance of Independence Day holiday.
    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until early July. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Sod installation, irrigation repairs and replacement of impacted landscaping will continue into the week of 7/6.
    • Paving the final layer of asphalt is tentatively scheduled for the week of 7/6.
    • Sign installation is scheduled to occur the week of 7/6.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Any outstanding sod issues are scheduled to occur the week of 7/6.
    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • No work will occur on Friday, July 3rd in observance of Independence Day holiday.
    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until early July. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Sod installation, irrigation repairs and replacement of impacted landscaping will continue into the week of 7/6.
    • Paving the final layer of asphalt is tentatively scheduled for the week of 7/6.
    • Sign installation is scheduled to occur the week of 7/6.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Any outstanding sod issues are scheduled to occur the week of 7/6.
    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Construction Update - 6/26/2026

    Share Construction Update - 6/26/2026 on Facebook Share Construction Update - 6/26/2026 on X (formerly Twitter) Share Construction Update - 6/26/2026 on Linkedin Email Construction Update - 6/26/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until early July. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Sod installation, irrigation repairs and replacement of impacted landscaping is scheduled to begin during the week of 6/29.
    • Paving the final layer of asphalt is tentatively scheduled for Monday, 7/6.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Any outstanding landscaping and sod issues are scheduled to occur the week of 6/29.
    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until early July. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Sod installation, irrigation repairs and replacement of impacted landscaping is scheduled to begin during the week of 6/29.
    • Paving the final layer of asphalt is tentatively scheduled for Monday, 7/6.
    • Check your front door daily for notifications.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Any outstanding landscaping and sod issues are scheduled to occur the week of 6/29.
    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Construction Update - 6/19/2026

    Share Construction Update - 6/19/2026 on Facebook Share Construction Update - 6/19/2026 on X (formerly Twitter) Share Construction Update - 6/19/2026 on Linkedin Email Construction Update - 6/19/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until late June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Asphalt driveway paving is scheduled to occur the week of 6/22.
    • Concrete sidewalk installation on Belmore Ln is scheduled to occur the week of 6/22.
    • Topsoil installation is scheduled to begin the week of 6/22.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until late June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Asphalt driveway paving is scheduled to occur the week of 6/22.
    • Concrete sidewalk installation on Belmore Ln is scheduled to occur the week of 6/22.
    • Topsoil installation is scheduled to begin the week of 6/22.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Construction Update - 6/12/2026

    Share Construction Update - 6/12/2026 on Facebook Share Construction Update - 6/12/2026 on X (formerly Twitter) Share Construction Update - 6/12/2026 on Linkedin Email Construction Update - 6/12/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until late June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Roadway grading in preparation for the first layer of paving will occur during the week of 6/15.
    • Paving of the first layer of asphalt on the streets is scheduled to occur late during the week of 6/15.
    • Asphalt driveway paving is scheduled to occur soon after the first layer of asphalt street paving occurs, likely during the week of 6/15.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until late June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction working hours.
    • Roadway grading in preparation for the first layer of paving will occur during the week of 6/15.
    • Paving of the first layer of asphalt on the streets is scheduled to occur late during the week of 6/15.
    • Asphalt driveway paving is scheduled to occur soon after the first layer of asphalt street paving occurs, likely during the week of 6/15.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Construction Update - 6/5/2026

    Share Construction Update - 6/5/2026 on Facebook Share Construction Update - 6/5/2026 on X (formerly Twitter) Share Construction Update - 6/5/2026 on Linkedin Email Construction Update - 6/5/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until late June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction.
    • Concrete curb and driveway apron installation will continue into the week of 6/8.
    • Concrete driveway installation is scheduled to begin during the week of 6/8.
    • Following concrete curing, roadway grading in preparation for the first layer of paving will occur.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until late June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction.
    • Concrete curb and driveway apron installation will continue into the week of 6/8.
    • Concrete driveway installation is scheduled to begin during the week of 6/8.
    • Following concrete curing, roadway grading in preparation for the first layer of paving will occur.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
  • Construction Update - 5/29/2026

    Share Construction Update - 5/29/2026 on Facebook Share Construction Update - 5/29/2026 on X (formerly Twitter) Share Construction Update - 5/29/2026 on Linkedin Email Construction Update - 5/29/2026 link

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until mid-June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction.
    • Work will occur on Saturday, 5/30.
    • Roadway excavation and soil corrections will continue into the week of 6/1.
    • Concrete curb and driveway apron installation is scheduled to begin late during the week of 6/1.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Please check your front door daily the week of 6/1 for notifications of driveway access loss due to concrete warranty work.
    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.

    Project Area

    • Maloney Ave will be CLOSED to through traffic between Washington Ave and Tyler Ave. This closure is expected to last until mid-June. Please see the attached detour map.
    • See the construction phasing map.
    • All work dates below are weather permitting.

    Phase 4:

    • Vehicles cannot be parked on the street during construction.
    • Work will occur on Saturday, 5/30.
    • Roadway excavation and soil corrections will continue into the week of 6/1.
    • Concrete curb and driveway apron installation is scheduled to begin late during the week of 6/1.
    • Check your front door daily for notification of temporary driveway access loss.
    • Please set out your garbage and recycling containers before 6 AM. We encouraged haulers to arrive early to avoid conflicts with the contractor and their operations.

    Phases 1, 2, 3

    • Please check your front door daily the week of 6/1 for notifications of driveway access loss due to concrete warranty work.
    • Sod watering continues. Residents will receive a letter in the mail when the sod watering period has concluded.
Page last updated: 24 Jul 2026, 01:36 PM
